Home Blog BIM for Facility Management

Using BIM for Facility Management: Benefits, Process, and Software

Using BIM for facility management turns the building model into a central hub for daily operations, where facility teams track assets, plan preventive maintenance, and monitor energy use across the building’s life. When the construction model is handed over with its asset data complete, the operations and maintenance team starts from those records instead of collecting them again.

Complete records make the benefits of facilities management using BIM possible, such as faster access to building information, better use of space, and stronger replacement decisions. Record accuracy decides how long those benefits last.

That accuracy is built during implementation, which starts with the tasks the facility team runs, because the fields each task needs decide what the handover model must contain. Named owners then keep those fields current whenever equipment or rooms change. The fields start as asset parameters in Autodesk Revit, and dedicated BIM facility management software such as Archibus and Autodesk Tandem carries them into operations after handover.

The sections below then cover the challenges that stop records from staying accurate, reaching the FM system, or keeping an owner, along with the standards that keep BIM data usable, why a 6D or 7D label does not guarantee FM data, and how to model an existing building.

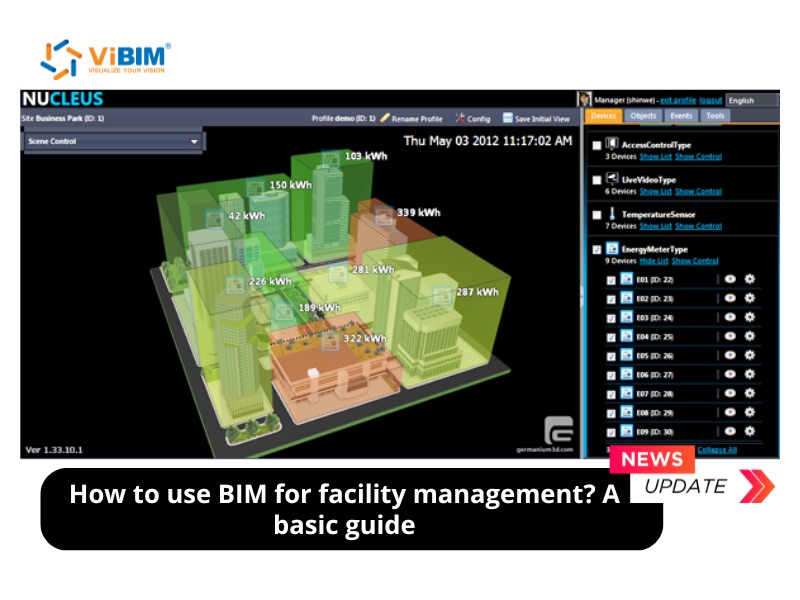

BIM facility management interface displaying building zones and energy readings
This BIM-linked facility interface shows building zones and energy readings.

What Is BIM for Facility Management?

BIM for facility management is the use of a data-rich building information model to operate and maintain a building after handover, with each space and maintainable asset linked to the specifications, maintenance schedules, and warranty records that operation and maintenance (O&M) teams rely on.

The Building Information Modeling model becomes the owner’s single source of truth for what each space and asset is and where it sits. Room records hold the number, area, and department, while equipment records hold the asset ID, type, warranty, and O&M manual. A building that was never modeled can still get one after construction, as an as-built model of its current condition.

In daily operations, the BIM model works alongside FM software, such as computer-aided facility management (CAFM) and computerized maintenance management system (CMMS) tools, and some owners also use a digital twin.

ToolWhat it does for the facility teamExample for one rooftop chiller
BIM modelHolds the record and location of every space and assetThe chiller’s position on the roof, the zones it serves, and its asset record
FM software (CAFM or CMMS)Runs the daily work, such as work orders, maintenance plans, and room bookingsThe quarterly work order and repair history for that chiller
Digital twinAdds live readings from sensors and meters to the modelThe chiller’s live supply temperature and power draw

All three tools point to the same chiller through its asset ID, so the work order in the CMMS and the live readings in the twin both land on the unit the model identifies.

How Is BIM Used in Facility Management?

BIM is used in facility management to locate assets, plan maintenance, allocate space, monitor energy use, plan renovations, and prepare safety responses, all from the records the model links to each room and asset.

The six uses of BIM in facilities management are listed below.

  • Asset management and equipment records: Facility teams locate a unit in the model and open its equipment record before raising a work order, using its asset ID, location, serial number, warranty date, and O&M manual.
  • Preventive and condition-based maintenance: Technicians plan service by each asset’s interval, or start work from an inspection or sensor reading, against the O&M instructions linked to that asset ID.
  • Space management, occupancy, and moves: Workplace teams allocate rooms, track occupancy against capacity, and schedule moves from each room’s boundary, measured area, use, and department.
  • Energy and building performance monitoring: Facility engineers monitor meter readings and building management system (BMS) data against the zones, systems, and equipment each meter or sensor serves in the model.
  • Renovation and retrofit planning: Designers plan new duct, pipe, and cable routes against the current geometry, MEP routes, and ceiling voids recorded in the model before drawings are issued.
  • Safety, compliance, and emergency response: Safety teams prepare emergency responses and compliance checks by retrieving the locations of fire-safety assets, shutoffs, and egress routes, together with their inspection records.

Selecting a slab in this federated architectural, structural, mechanical, and electrical model opens its IFC entity, external ID, and property sets, the same kind of record an FM team extends with asset and warranty fields.

BIM viewer showing a federated architectural, structural, mechanical, and electrical model with linked object properties.
Linked object properties let facility teams inspect model records in spatial context.

What Are the Advantages of Using BIM for Facility Management?

The main advantages of using BIM for facility management are faster access to building information, more planned maintenance, better use of space, stronger lifecycle decisions, fewer coordination errors, and clearer accountability at handover. Unlike the design and construction benefits of Building Information Modeling, these advantages start at handover and last only while the model data stays accurate and current, and most also depend on its link to the FM system.

Six advantages of BIM for facility management with enabling conditions
Each advantage of BIM for facility management is shown with the condition it depends on.

The six main advantages of using BIM for facility management are listed below.

1. Faster Access to Building Information

BIM gives facility teams faster access to building information because every room and asset in the model carries its own specifications, warranty, and manuals. Asset management and equipment records make this possible, because a stable asset ID ties each model object to its linked documents. A technician sent to a failed pump can check its model number, serial number, and warranty status before leaving the office, instead of searching binders or a shared drive on site.

2. More Planned Maintenance and Less Reactive Repair

BIM shifts maintenance from reactive repair to planned work by tying each asset’s service interval and O&M instructions to its place in the model. Preventive and condition-based maintenance delivers that shift once each asset is mapped to the CMMS and its service rules are set there. Filter changes on a rooftop air-handling unit then follow the manufacturer’s interval, so the team books the visit before anyone reports poor airflow.

3. Better Use of Space

BIM improves the use of space by showing measured room areas, assignments, and capacity together, so moves are planned against real floor data. Space management, occupancy, and moves relies on two current sources, the model for room boundaries and the CAFM or IWMS for department and occupancy records. A workplace team merging two departments onto one floor can compare each room’s area with its headcount before approving the move and pick out rooms that sit empty.

4. Stronger Lifecycle and Replacement Decisions

BIM supports stronger lifecycle and replacement decisions by keeping each asset’s install date, condition history, and expected service life in one record. Preventive and condition-based maintenance builds that record over time, as every completed work order adds to the asset’s condition history. A facility manager setting next year’s capital budget can rank chillers by age, repair count, and energy use, then replace the units that cost the most to run and repair before they fail.

5. Fewer Coordination Errors in Renovation Work

BIM reduces coordination errors in renovation work because designers check new duct, pipe, and cable routes against verified as-built geometry before work starts. Renovation and retrofit planning gets this benefit only from an existing model surveyed to a known tolerance. A new supply duct planned through a crowded ceiling void can be tested against sprinkler mains and cable trays in the model, so the clash surfaces in design review, before a contractor has cut or ordered anything.

6. Clearer Accountability at Handover

BIM makes accountability at handover clearer by recording who approved each asset dataset and who must update it once the building is in operation. Asset management and equipment records carry that record forward, because BIM for FM handover passes each equipment dataset to operations together with who supplied and approved it. When a contractor hands over a new wing, the facility team can trace a missing warranty date straight to the subcontractor who supplied that equipment and close the gap before the warranty period runs out.

How Do You Implement BIM for Facility Management?

To use BIM for facility management, define the information your FM tasks need, validate the handover model against the building, structure its spaces and assets, connect it to your FM systems, and assign owners who keep it current. Each step produces the data the next one needs, and a skipped step leaves gaps that no FM software can repair later.

Five-step BIM facility management implementation process from requirements to governance
The five implementation steps run from FM information requirements to named information owners.

The five steps to implement BIM for facility management are listed below.

  1. Define FM Use Cases and Information Requirements
  2. Validate the Handover or As-Built Model
  3. Structure Spaces, Assets, and Classifications
  4. Connect the Model to the CDE and FM Systems
  5. Assign Information Owners and Maintain the Model

Step 1. Define FM Use Cases and Information Requirements

Define the FM use cases and information requirements by listing the tasks the model must support and the fields each task needs for spaces, assets, and documents. The approved list becomes the brief that modelers, contractors, and FM software vendors deliver against, so each field needs a pass-or-fail check.

The field groups for FM information requirements are listed below.

  • Spaces: Every room needs a room ID, name, area, and department, and the check is that every room on the floor plans appears with its area filled in.
  • Assets: Every maintainable asset needs an asset ID, type, manufacturer, serial number, warranty date, and location, and the check is that no required value is blank.
  • Documents: Every asset links to its O&M manual, warranty certificate, and inspection records, and the check is that each link opens the approved file.

Step 2. Validate the Handover or As-Built Model

Validate the handover or as-built model by checking its geometry against current site conditions and its asset data against the agreed FM fields before anyone relies on it.

In a new building, the contractor’s construction model may have accurate walls and routes yet still lack asset IDs, serial numbers, or warranty dates, so those gaps are listed and filled before handover is accepted. In an existing building with no reliable model, Scan to BIM creates one from a registered laser scan point cloud.

Coordinated ductwork, piping, and electrical routes like the ones in this MEP model are checked for position and clearance against the site before the model is accepted.

Coordinated MEP BIM model showing HVAC, piping, and electrical systems.
Coordinated system geometry supports route, clearance, and equipment-relationship checks.

Step 3. Structure Spaces, Assets, and Classifications

Structure the model so every space, asset, and system has a unique ID, a classification, and a location link, because FM software matches records by those IDs.

ISO 12006-2 sets the framework for classifying construction information, and each project picks a system built on it, such as Uniclass in the UK or OmniClass in North America, so names and groupings stay consistent. Before mapping the whole model, test one room and one asset in the target FM system to confirm that their IDs, classes, and locations resolve.

Step 4. Connect the Model to the CDE and FM Systems

Connect the model to a common data environment (CDE) and to your CAFM, CMMS, or IWMS through a native connector, an API, IFC, or a COBie export, then test sample records on both sides. The connection is complete when sample records keep every required value and open the right room or asset.

Decide which system owns each field before the first import, for example the model for location and the CMMS for work history, so two systems never overwrite the same value.

Step 5. Assign Information Owners and Maintain the Model

Assign a named owner to each information set and update the model and FM records together whenever equipment, rooms, or documents change.

When a pump is replaced, the owner closes the old asset record, issues a new asset ID, updates both the model and the CMMS, and attaches the new O&M manual and warranty. Each change is logged with its date and approver, and periodic spot checks of sampled rooms and assets against the building catch changes that were missed.

What Software Is Used for BIM Facility Management?

The software used for BIM facility management connects 3D building models with long-term maintenance, space planning, and asset tracking, and it falls into two groups, dedicated BIM facility management platforms and design and coordination tools used in operations. Dedicated platforms take on CAFM, CMMS, IWMS, or digital twin roles after handover.

The dedicated BIM facility management platforms are listed below.

  • Archibus: Archibus manages real estate, space, assets, and maintenance, and its extension for Revit links model elements to Archibus asset records.
  • Autodesk Tandem: Autodesk Tandem builds a digital twin from design and construction models, so facility teams keep tracking assets and building data after handover.
  • EcoDomus: EcoDomus extends BIM models into operations and maintenance and works as COBie middleware, a tool that checks and transfers COBie handover data.
  • usBIM.maint: ACCA’s usBIM.maint tracks maintenance on IFC models stored in a common data environment (CDE), so each work order stays linked to an openBIM object.

The design and coordination tools used in operations are listed below.

  • Autodesk Revit: Autodesk Revit creates the model geometry and the asset parameters, such as asset IDs, serial numbers, and warranty dates, that FM platforms import.
  • Revizto: Revizto tracks issues in 2D and 3D, pinned to their exact location in the model, so renovation and coordination teams can review problems against the building.

In this diagram, the source model built in Revit passes through a CDE and an exchange and mapping step before CAFM, CMMS, or IWMS platforms use it, with BAS and sensor readings as an optional input.

BIM software architecture connecting authoring CDE exchange and FM platforms
Authoring tools, the CDE, the exchange step, and FM platforms each play a separate role in the software chain.

CAFM, CMMS, and IWMS platforms sit at the end of that chain, where the model’s data must enter their own records.

Can Facilities Management Software Integrate With BIM Models?

Yes, facilities management software, including many CAFM, CMMS, and IWMS platforms, can integrate with BIM models, usually through IFC, COBie, or a vendor connector, but only the fields mapped in advance arrive intact. A one-way import copies model data once, while a two-way connector keeps later edits in the FM system and the model in step.

What Are the Challenges of Using BIM for Facility Management?

The main challenges of using BIM for facility management are models that no longer match the building, data that cannot reach the FM system, and records with no owner after handover. BIM supports facility management only when all three are solved, since an accurate model and its as-built documentation stop matching the building after the next renovation if nobody updates them.

Each challenge has a warning sign that shows up in daily work before it causes a wrong decision.

ChallengeWarning sign
Model no longer matches the buildingTechnicians find equipment the model does not show, or miss equipment it does
Data cannot reach the FM systemImported records arrive with blank fields or IDs that match no room or asset
Records have no owner after handoverNobody knows who updates a replaced asset, so staff return to spreadsheets

FM data standards, contract terms that replace 6D or 7D labels, and as-built models of existing buildings tackle the first two challenges at their source, and the named owners set in Step 5 solve the third.

Which Standards Keep BIM Data Usable for Facility Management?

The three standards that keep BIM data usable for facility management are ISO 19650-3 for operational information management, IFC for vendor-neutral model exchange, and COBie for asset handover data.

  • ISO 19650-3: ISO 19650-3 sets the information management process for the operational phase of an asset, including how an owner specifies, receives, and approves information exchanges.
  • IFC: Industry Foundation Classes (IFC) is the open data schema maintained by buildingSMART International and published as ISO 16739-1, so different software can read the same model data without a proprietary format.
  • COBie: COBie, short for Construction Operations Building information exchange, is a data format, most often delivered as a spreadsheet, for handing over spaces, equipment, and documents to FM systems.

Is 6D or 7D BIM the Same as BIM for Facility Management?

No, 6D or 7D BIM is not the same as BIM for facility management, because sources disagree on which dimension label covers FM. Some BIM dimension guides label facility management as 7D, while NBS notes that others treat 6D as adding facility management, with little industry consensus. Instead of asking for a 6D or 7D model, write the spaces, asset fields, documents, and exchange format you need into the contract, so the data your FM system expects is delivered.

Digital twin is a third label sometimes swapped in for an FM-ready model, even though an FM-ready model can work without any live data, a point developed in Digital Twin vs BIM.

How Do You Get a BIM Model for an Existing Building?

You get a BIM model for an existing building by laser scanning it, registering the scans into a point cloud, and modeling the as-built conditions in software such as Revit. A laser scan gives facility managers a digital record of the building’s geometry and the position of visible equipment, but not the data printed on nameplates or kept in the owner’s files.

Data the FM model needsWhere it comes from
Room geometry, areas, and clearancesThe laser scan
Position and size of visible equipment, ducts, and pipesThe laser scan
Services hidden above ceilings or inside wallsExisting drawings or a targeted site survey
Manufacturer, model, and serial numberNameplates captured in site photos
Warranty dates and service historyO&M manuals and the owner’s maintenance records
Room names, departments, and occupancyThe owner’s space records

For buildings without dependable drawings, Scan to BIM services produce the as-built geometry, which covers two of the six data types. The other four decide how much site time and document collection the FM model needs.

How Does ViBIM Prepare Existing Buildings for BIM-Based Facility Management?

ViBIM prepares existing buildings for BIM-based facility management by modeling them in Revit from point cloud data and filling FM parameters from client documents and site photos. The fields follow the owner’s asset information requirements or Master Tag Register. The deliverables are a Revit model with FM parameters, an Excel asset data workbook, COBie or IFC files configured for the client’s CAFM or CMMS, and handover documentation that explains every field and code.

Survey and AEC firms can send a scan or an existing Revit model to ViBIM’s scan to BIM for FM services. Independent QC reviewers check asset IDs, tags, and parameter values before any model is issued, and ViBIM checks each visible asset’s location against the point cloud at the client’s tolerance. ViBIM delivers that work through its Revit Modeling Services team, which has logged more than 250,000 hours of Scan to BIM delivery.

ViBIM Revit modeling team supporting Scan-to-BIM delivery for existing buildings.
ViBIM’s Revit modeling team supports existing-building BIM delivery.

Sources

The standards and industry guidance on BIM for facility management are listed below.
